    NYC OER E-Designation Removal: The Roadmap from (E) to Clean Title

    An NYC E-designation can turn a promising development site into a financing problem.

    The designation appears in zoning records because a prior zoning action identified potential requirements related to hazardous materials, air quality, or noise. Until those requirements are addressed, your project may face delays with building permits, certificates of occupancy, lender approval, closing, or redevelopment planning.

    The good news: an NYC OER E-designation isn’t permanent. With the right investigation, remedy, documentation, and agency coordination, you can move from (E) to a property with the designation administratively removed from the Zoning Resolution.

    The process is technical. It isn’t mysterious. The key is defining the correct endpoint before work begins.

    “OER can remove all E-Designations from a property that achieves a high level of cleanup and fully meets air quality and noise requirements.” : NYC Office of Environmental Remediation

    What an NYC E-Designation Means

    New York City places an E-designation on a property as a result of a zoning action. The designation identifies environmental requirements that must be investigated and addressed before redevelopment can proceed.

    The NYC Office of Environmental Remediation manages three primary categories:

    • Hazardous materials: Soil testing, site investigation, and: if contamination is confirmed: an OER-approved Remedial Action Plan.
    • Air quality: Requirements may affect boiler fuel, stack placement, or other building systems.
    • Noise: Requirements may include specific window and wall attenuation, alternate means of ventilation, or acoustic design measures.

    The designation can affect more than construction. It can also raise questions during:

    • Acquisition due diligence
    • Lender underwriting
    • Title review
    • Environmental insurance placement
    • Construction budgeting
    • Sale or refinance discussions

    An E-designation doesn’t automatically mean the property is contaminated. It means the City requires environmental conditions to be evaluated and resolved before the site reaches its approved development outcome.

    That distinction matters. A vague consultant report may confirm that an E exists. It won’t necessarily tell you how to remove it.

    The Standard for NYC OER E-Designation Removal

    Under 43 RCNY § 1475, OER must determine that the applicable environmental requirements have been completed and that the site meets the conditions for removal.

    In practical terms, full E-designation removal generally requires three things:

    1. The site remedy is complete.
    2. The property reaches its full zoning development potential.
    3. All applicable hazardous materials, air quality, and noise requirements are satisfied and certified by OER.

    The remedy must also meet OER’s standard for a high level of cleanup. If the property requires an active soil vapor management system, that can affect eligibility for full removal. The project may need to continue operating under the applicable control requirements until OER confirms that all conditions have been satisfied.

    This is why your desired endpoint needs to be discussed at the beginning: not after soil is excavated, the building is designed, or financing is already under pressure.

    The Roadmap from (E) to Clean Title

    Step 1: Confirm the Designation and Tax Lots

    Start by confirming exactly what applies to the property.

    Review the relevant zoning records, tax lots, and environmental documents. Use NYC’s E-designation resources and “Do I Have an E?” tools to identify whether the designation relates to:

    • Hazardous materials
    • Air quality
    • Noise
    • Multiple environmental categories
    • One or more tax lots within a larger zoning action

    A designation may apply differently across a development assemblage. Treating an entire project as one uniform site can create avoidable gaps in investigation and documentation.

    You also need to identify whether a restrictive declaration, prior remedial document, or other recorded obligation affects the property.

    Step 2: Define the Business Objective

    Not every owner needs the same outcome.

    Some projects need an OER-approved pathway to obtain permits and a certificate of occupancy. Others need the designation removed before a closing, refinance, disposition, or long-term hold.

    Those are different objectives.

    A remedy that allows construction to proceed may still rely on:

    • A vapor barrier
    • An active sub-slab depressurization system
    • A soil or groundwater management plan
    • A cap or other engineering control
    • An environmental restrictive declaration
    • Long-term operation and maintenance requirements

    Those controls may be appropriate for the project. But they can prevent the property from reaching the “clean title” endpoint that a buyer, lender, or investment committee expects.

    Before selecting a remedy, ask:

    • Do we need permit clearance, full E-designation removal, or both?
    • Will the proposed remedy require active controls?
    • Does the design achieve the property’s full zoning development potential?
    • Will air and noise requirements be fully installed and documented?
    • What will remain on title after completion?

    Envicon helps clients answer those questions before they commit to a cleanup strategy.

    Technical cutaway illustration of urban soil strata, groundwater, monitoring wells, and a resolved vapor pathway

    Step 3: Choose the Right OER Pathway

    Most projects follow one of two paths.

    E-Designation Compliance

    Under the standard NYC OER E-designation process, the project team investigates the site, prepares the necessary plans, implements the approved remedy, and submits final documentation for OER review.

    For hazardous materials, that may include:

    • Phase I Environmental Site Assessment
    • Phase II or Remedial Investigation
    • Soil, soil gas, and groundwater sampling
    • Sampling and Analysis Plan
    • Remedial Action Plan
    • Construction Health and Safety Plan
    • Community Air Monitoring Plan
    • Remedial Closure Report

    Air and noise requirements may require separate design and installation documentation, including information from architects, mechanical engineers, acoustical consultants, and contractors.

    NYC OER Voluntary Cleanup Program

    The NYC OER Voluntary Cleanup Program can provide a structured alternative for eligible properties.

    The VCP may offer:

    • Liability protection tied to the OER-approved remedy
    • Assignable protections for successors and assigns that follow program requirements
    • City grants typically ranging from $25,000 to $50,000
    • Free soil disposal through the Clean Soil Bank, aside from trucking costs
    • Exemption from applicable New York State hazardous waste fees
    • A formal Notice of Completion after successful program completion

    The VCP isn’t automatically the best choice for every E-designated property. The right program depends on contamination, ownership, redevelopment plans, schedule, liability concerns, and the desired title outcome.

    Step 4: Investigate the Site to the Correct Standard

    A Phase I report alone rarely resolves an E-designation.

    The investigation must give OER enough information to understand the nature, extent, and potential exposure pathways at the site. Depending on conditions, that may require:

    • Soil borings across suspected source areas
    • Groundwater monitoring wells
    • Soil vapor points
    • Indoor or sub-slab vapor evaluation
    • Laboratory analysis for petroleum, VOCs, SVOCs, metals, PCBs, or other constituents
    • Confirmation sampling after excavation
    • Off-site disposal or reuse documentation

    The scope should reflect the property’s history and proposed development: not a generic template.

    For a former industrial site in Brooklyn, Queens, the Bronx, or Hudson County, the likely concerns may differ from those at a former dry cleaner, auto repair facility, manufactured gas plant, or commercial property with historic fuel storage.

    That is where local experience matters. A technically correct investigation can still lose time if it doesn’t answer the questions OER will ask next.

    Step 5: Implement and Document the Remedy

    Once OER approves the applicable plan, the remedy must be implemented in the field.

    This is where many projects separate the report from the result.

    Environmental oversight should track:

    • Soil excavation limits
    • Stockpile management
    • Waste characterization
    • Trucking and disposal records
    • Confirmation sample locations
    • Imported clean fill
    • Vapor mitigation installation
    • Air monitoring
    • Field changes and contractor coordination
    • As-built conditions

    All project filings go through the EPIC Environment portal. The documentation must be organized so OER can verify what happened, where it happened, and whether the completed work matches the approved remedy.

    A missing manifest, inconsistent sampling location, or undocumented field change can create another review cycle. That means more time, more mobilization, and more cost.

    Technical flat-lay of environmental closeout documentation, site plans, sample vials, and an approval stamp

    Step 6: Obtain OER Certification and DCP Removal

    After the remedy and applicable air and noise requirements are complete, the project submits its closeout package to OER.

    For an E-designation project, OER may issue a final Notice of Satisfaction or equivalent certification confirming that the environmental requirements have been met.

    For a VCP project, OER may issue a Notice of Completion. If the property also carries an E-designation, the project must still satisfy the requirements for that designation and obtain the appropriate OER confirmation.

    Once OER certifies completion, the Department of City Planning administratively removes the E-designation from the Zoning Resolution for the applicable property or tax lots. The City then updates the relevant records and notifies the agencies responsible for enforcing the designation.

    This is the step that converts technical completion into a meaningful zoning outcome.

    It’s also important to use precise language. E-designation removal is not the same as a guarantee that a property has no environmental history or that every title issue has disappeared. It means the property has satisfied the applicable NYC E-designation requirements and achieved the conditions for administrative removal.

    Your attorney and title company should review the final agency documents and recorded instruments as part of the transaction.

    Why the Consultant Matters

    Large firms often make NYC OER compliance feel like a black box. You receive a report, wait for an update, and discover late in the process that the proposed remedy won’t support full removal.

    Envicon takes a different approach.

    We coordinate directly with developers, investors, attorneys, architects, engineers, contractors, and agency reviewers. Our team stays close to the field conditions and the closing or construction deadline. We don’t just document the problem. We build a path to resolution.

    That includes:

    • Defining the removal endpoint early
    • Matching the investigation to the property’s actual history
    • Coordinating OER submissions through EPIC
    • Tracking field work and closeout documentation
    • Identifying vapor, air, noise, and title constraints before they become surprises
    • Giving clients clear status visibility instead of outdated monthly summaries
    • Taking responsibility from the first investigation through agency closeout

    We’ve spent 20 years working across New York and New Jersey. We understand that a project can’t wait for a consultant’s internal queue.

    What to Do If an E-Designation Is Delaying Your Deal

    Before you accept another extension or approve another round of consulting fees, gather:

    • The property address and tax lot numbers
    • The E-designation type
    • Prior environmental reports
    • Existing OER correspondence
    • Any Notice of Satisfaction or Notice of Completion
    • Restrictive declarations or other title documents
    • Proposed development plans
    • Current lender or buyer requirements
    • Known soil vapor, air quality, or noise controls

    Then have an experienced NYC environmental consultant map the remaining steps to the actual business objective.

    The Takeaway

    NYC OER E-designation removal requires more than completing a Phase II or submitting a closure report.

    You need a coordinated process that connects:

    • Site investigation
    • Remedy design
    • Field implementation
    • Air and noise compliance
    • EPIC filings
    • OER certification
    • DCP administrative removal
    • Title and transaction requirements

    The earlier you define the endpoint, the fewer surprises your project will face.

    Envicon Group helps developers, investors, and attorneys turn environmentally constrained properties into clean, buildable, compliant assets. We solve environmental and engineering challenges with precision, speed, and trust: and we stay at the table until the path is clear.

    Talk with Envicon About Your NYC E-Designation

    Envicon Group logo

  • Property Condition Report ASTM E2018-24: Lender-Ready PCA for New York and New Jersey Commercial Property

    Property Condition Report ASTM E2018-24: Lender-Ready PCA for New York and New Jersey Commercial Property

    A commercial acquisition can look strong on paper and still carry major repair exposure. Roof failure, aging HVAC equipment, deteriorated masonry, obsolete electrical infrastructure, and deferred maintenance can change underwriting before closing.

    A property condition report ASTM E2018 assessment gives lenders, investors, and acquisition teams a consistent way to evaluate those risks. For commercial properties in New York City, Jersey City, Newark, Bergen County, and Hudson County, the report should do more than list defects. It should identify what matters now, what will matter later, and what each issue may cost.

    Envicon prepares lender-ready Property Condition Assessments and Property Condition Reports for single assets and commercial portfolios. Our reports are prepared under licensed Professional Engineer oversight and can be coordinated with a Phase I Environmental Site Assessment when the transaction requires both physical and environmental due diligence.

    “The goal of the baseline process for property condition assessments is to identify and communicate material physical deficiencies to a user.”
    ASTM E2018-24, ASTM International

    What ASTM E2018-24 covers

    ASTM E2018-24 is a baseline guide for performing a Property Condition Assessment, or PCA, of the primary improvements on a commercial property. The resulting Property Condition Report, or PCR, combines:

    • A site reconnaissance and building walkthrough
    • Review of available property documents and records
    • Interviews with owners, occupants, operators, and other knowledgeable parties
    • Identification of material physical deficiencies
    • Immediate repair recommendations
    • Opinions of probable cost
    • Capital reserve recommendations for major future repairs and replacements

    The assessment is site-specific and reflects conditions observed and researched at a particular point in time. It is not designed to eliminate every uncertainty. It establishes a practical level of due diligence for lenders and acquisition teams without requiring destructive testing or a technically exhaustive investigation.

    For a property condition assessment for real estate acquisition, the scope should be agreed upon before the site visit. The age, size, use, number of buildings, transaction schedule, lender requirements, and risk tolerance all affect the appropriate level of review.

    What a lender-ready PCA includes

    1. Document review and interviews

    The document review helps the consultant understand the property before and during the site visit. Available records may include:

    • Prior Property Condition Reports
    • Architectural, structural, mechanical, and electrical drawings
    • Construction records and renovation documents
    • Roof warranties and maintenance logs
    • Equipment service records
    • Building permits and certificates of occupancy
    • Fire department records and material violation information
    • Open building violations
    • Utility bills and operating information
    • Capital improvement plans
    • Previous repair proposals and contractor estimates

    Interviews also matter. An owner, property manager, superintendent, or facility operator may know about recurring leaks, equipment that operates only intermittently, or repairs that never reached completion.

    A missing record is not automatically a deficiency. It is a data point. The report should state what was available, what was not available, and how the information gap affects the assessment.

    2. Site reconnaissance

    The site reconnaissance is a visual, non-intrusive walkthrough of accessible areas. The field observer evaluates representative conditions and documents concerns with photographs and written observations.

    For a New York or New Jersey commercial property, the walkthrough commonly includes:

    • Parking areas, drives, sidewalks, curbs, and site drainage
    • Retaining walls, fencing, site lighting, and landscaping
    • Foundations and visible structural components
    • Exterior walls, windows, doors, sealants, and waterproofing
    • Roof surfaces, flashings, drains, penetrations, and rooftop equipment
    • Interior finishes and representative tenant or common areas
    • Mechanical, electrical, plumbing, and fire protection systems
    • Elevators and other vertical transportation systems, when present
    • Accessible routes, ramps, stairs, handrails, and obvious access concerns
    • Fire exits, emergency lighting, fire alarm components, and sprinkler systems

    Accessibility observations in a baseline PCA are limited. They may identify obvious barriers or concerns that warrant additional review. They do not replace a formal ADA or accessibility compliance survey.

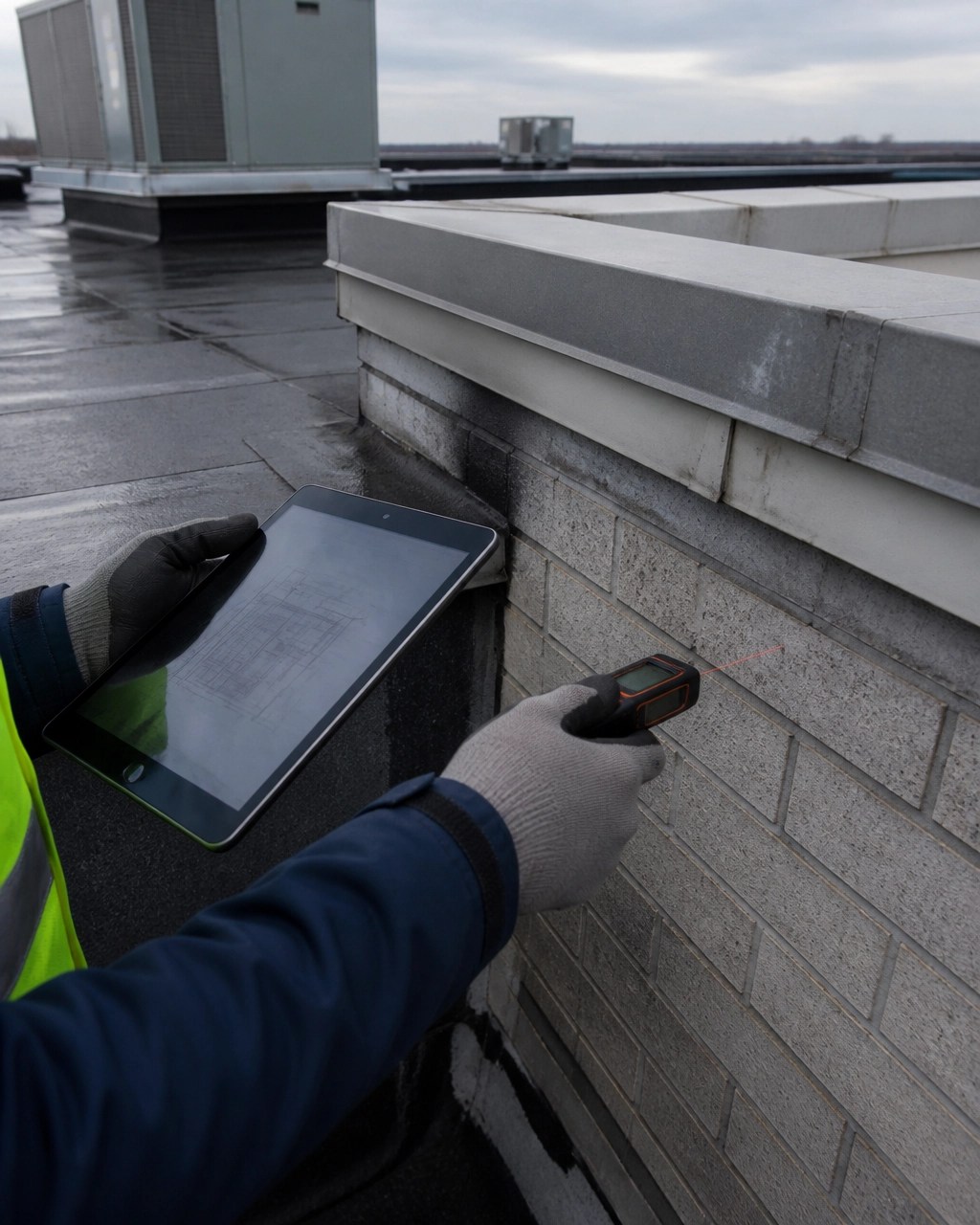

    Technical roof and building envelope inspection showing membrane seams, flashing, parapet coping, and rooftop HVAC equipment

    3. Building systems evaluation

    A useful PCA connects observed conditions to building performance and likely capital needs.

    Roof

    The roof review typically considers:

    • Membrane or shingle condition
    • Ponding water
    • Flashing and edge metal
    • Roof drains and leaders
    • Penetrations and rooftop equipment curbs
    • Evidence of active or historic leaks
    • Approximate remaining useful life

    The PCA does not normally include core cuts, moisture mapping, or destructive testing. If the roof appears near failure or concealed moisture is suspected, the report should recommend a qualified roofing investigation.

    Structure and foundation

    The field observer looks for readily visible indicators such as:

    • Significant cracking
    • Settlement or movement
    • Water intrusion
    • Deteriorated concrete or masonry
    • Corrosion at exposed structural steel
    • Deflected floors or roof framing
    • Damaged stairs, balconies, or retaining walls

    The report can identify conditions that warrant further investigation. It does not provide structural calculations, load ratings, foundation design, or a professional structural engineering investigation unless that work is separately authorized.

    Building envelope

    The envelope review includes exterior walls, windows, doors, joints, sealants, and waterproofing components. In older urban properties, particular attention should go to brick deterioration, parapets, lintels, coping stones, façade attachments, and recurring water entry.

    MEP systems

    Mechanical, electrical, and plumbing systems often represent the largest capital reserve exposure. A PCA may review:

    • Boilers, chillers, rooftop units, and split systems
    • Distribution piping and pumps
    • Electrical service, panels, transformers, and emergency power
    • Domestic water and sanitary plumbing
    • Hot water equipment
    • Fire pumps, sprinkler piping, alarms, and extinguishers
    • Elevators and controls, based on available access and records

    The assessment documents apparent age, observed condition, maintenance concerns, and estimated replacement timing. It does not verify concealed system conditions or guarantee future performance.

    Commercial mechanical room with boilers, pumps, electrical panels, conduit, fire protection piping, and inspection documentation

    Immediate repairs, physical deficiencies, and capital reserves

    A lender needs to distinguish between a repair that requires prompt action and a capital item that belongs in long-term planning.

    Immediate repairs

    Immediate repairs may include conditions involving:

    • Life safety
    • Active water intrusion
    • A system with a credible risk of near-term failure
    • Unsafe access or egress
    • Conditions that could cause additional property damage
    • Significant deterioration requiring prompt stabilization

    The report should explain the condition, recommended action, priority, and opinion of probable cost.

    Material physical deficiencies

    A material physical deficiency is more than ordinary wear. It is a condition that may affect the building’s function, safety, value, or expected useful life. The consultant should describe the observed condition in plain language and avoid burying important findings in a long narrative.

    Capital reserve recommendations

    Capital reserves address predictable major repairs and replacements over a defined planning period. Envicon commonly provides a 12-year replacement reserve table for lender and acquisition work.

    Typical reserve items include:

    • Roof replacement
    • Boiler or HVAC replacement
    • Parking lot rehabilitation
    • Façade repairs
    • Window replacement
    • Elevator modernization
    • Electrical service upgrades
    • Plumbing riser replacement
    • Fire protection system upgrades
    • Site drainage improvements

    Opinions of probable cost are not contractor bids. They are planning-level estimates based on observed conditions, system age, replacement assumptions, regional pricing, and the limits of the PCA scope.

    Commercial real estate acquisition planning desk with inspection photographs, building plans, and a capital reserve schedule

    What a PCA does not replace

    A PCA is one part of commercial real estate due diligence. It should not be presented as a substitute for specialized investigations.

    Assessment Primary purpose Typical deliverable What it does not replace
    ASTM E2018-24 PCA Evaluate physical condition and capital needs Property Condition Report with cost opinions Specialized testing or design
    Structural engineering investigation Evaluate structural capacity, distress, or safety Engineering report, calculations, or repair design A baseline PCA
    Phase I ESA Identify recognized environmental conditions ASTM E1527-21 environmental report A physical building condition review
    Asbestos survey Identify asbestos-containing materials Inspection and sampling report A PCA or environmental ESA
    Code or accessibility certification Evaluate compliance with applicable requirements Formal compliance report or certification Limited PCA observations

    For environmental due diligence, pair the PCA with Envicon’s ASTM E1527-21 Phase I ESA services. For subsurface, site, drainage, or foundation-related concerns, our civil and geotechnical engineering team can develop the next scope.

    Lender deliverables checklist

    Before ordering a PCA, confirm that the final package includes:

    • Property address and legal description
    • Purpose, intended user, and reliance requirements
    • ASTM E2018-24 scope statement
    • Description of buildings and site improvements
    • Document review summary
    • Interview summary
    • Site reconnaissance date and weather conditions
    • Photographic documentation
    • Roof, envelope, structural, MEP, and life safety observations
    • Limited accessibility observations, if included
    • Immediate repair table
    • Material physical deficiency table
    • Capital reserve schedule
    • Opinions of probable cost
    • Remaining useful life assumptions
    • Limiting conditions and access restrictions
    • Consultant qualifications
    • Licensed Professional Engineer review, where required by the engagement
    • Clear distinction between observed conditions and recommended further investigation

    A lender may also have its own template, reliance language, reserve horizon, or minimum consultant qualification requirements. Those requirements should be provided before fieldwork so the report supports the actual closing process.

    Why local delivery matters in NY and NJ

    Commercial assets in Manhattan, Jersey City, Newark, Bergen County, and Hudson County have different construction histories, building types, agency environments, and operating constraints. A former industrial building in Jersey City may require a different acquisition strategy than a prewar office building in Manhattan or a warehouse portfolio in Newark.

    Envicon works across the NY/NJ metro area with direct senior-level coordination, licensed engineering oversight, and field-first reporting. From our Jersey City office, we support Hudson County and nearby commercial portfolios with practical schedules, transparent scopes, and reports designed to help the transaction move forward.

    A large report is not the objective. A clear decision is.

    Frequently asked questions

    What is a property condition report ASTM E2018?

    It is the written report produced after a Property Condition Assessment performed using the ASTM E2018 framework. It documents observed building and site conditions, material physical deficiencies, recommended repairs, and opinions of probable cost.

    Is ASTM E2018-24 mandatory?

    ASTM E2018-24 is a voluntary industry guide. A lender, investor, or transaction agreement may require an assessment prepared in accordance with the current edition. Confirm the requirement before authorizing the work.

    How long does a commercial property condition report take?

    Schedule depends on property size, access, document availability, and lender requirements. Envicon’s standard service page identifies a typical 5 to 7 business day turnaround for a standard PCR after access and scope confirmation.

    Does a PCA include a Phase I ESA?

    No. A PCA evaluates physical building and site condition. A Phase I ESA evaluates potential environmental conditions and follows ASTM E1527-21. Many lenders require both reports.

    Does a PCA certify code or ADA compliance?

    No. A baseline PCA may document obvious life safety or accessibility concerns, but it is not a code certification, formal ADA survey, or regulatory compliance audit.

    Can Envicon assess a portfolio?

    Yes. Envicon offers portfolio PCR coordination with individual property reports and a consolidated capital expenditure analysis for multi-property acquisitions.

    The takeaway

    An ASTM E2018-24 PCA gives your lender and acquisition team a disciplined view of the property’s physical risk. The strongest report does not simply catalog defects. It ranks them, prices them, explains uncertainty, and connects immediate repairs to long-term capital planning.

    For commercial property in New York and New Jersey, the right PCA helps you negotiate from facts and close with fewer surprises.

    Start your lender-ready PCA

    Envicon Group logo

  • Maria F. Cardenas Named to NYREJ 2026 Women in Commercial Real Estate Spotlight

    Maria F. Cardenas Named to NYREJ 2026 Women in Commercial Real Estate Spotlight

    Published August 26, 2026

    Jersey City, NJ. The New York Real Estate Journal has named Maria F. Cardenas to its 2026 Women in Commercial Real Estate Spotlight, published in the journal's August 26 issue.

    Maria leads operations and people at Envicon. Her responsibility has grown well past the role she was hired into, and it grew the way it should: by earning the trust of our clients and the respect of her colleagues.

    Most of what she does is invisible when it works. Schedules that hold. Agency deadlines that get met. Contractors, counsel, lenders, and owners who all have the same understanding of where a project stands. When a site condition changes, the client hears it from us that day, not at the next progress meeting.

    That standard is why developers come back to us. Envicon competes with firms many times our size on brownfield redevelopment, Phase I and Phase II ESAs, E-Designation closeouts, and remediation oversight across New York City and Northern New Jersey. We do not win those pursuits on headcount. We win them because clients get a clear read and a defensible position, and because it holds up.

    Maria also sets the example for our team in a field that remains overwhelmingly male. Prepared, direct, accountable. Our younger staff calibrate to it.

    Congratulations, Maria. The recognition is well earned.

    Read Maria's full NYREJ profile: https://nyrej.com/2026-wicre-maria-cardenas-envicon-group

    Working through an environmental condition on a site?

    Talk to the team directly. (917) 764-2171 or Contact Envicon.

    Envicon Group logo

  • PFAS in Biosolids: New NY/NJ Rules Reshaping Land Application

    PFAS in Biosolids: New NY/NJ Rules Reshaping Land Application

    As of August 2026, PFAS in biosolids is no longer a future compliance issue for New York and New Jersey wastewater operators, agricultural users, municipalities, and environmental counsel. It is an active sampling, reporting, and land-management issue.

    The regulatory picture is not identical in both states:

    • New York has interim PFAS thresholds that can restrict or stop biosolids recycling.
    • New Jersey has imposed targeted quarterly PFAS monitoring while developing a broader residuals strategy.
    • EPA has not yet established federal PFAS limits for biosolids land application.

    For any facility that produces, transports, applies, composts, or distributes biosolids, the practical message is simple: test early, document the source, understand the receiving site, and build a response plan before a result creates a scheduling or disposal problem.

    Why PFAS in biosolids matters

    PFAS: per- and polyfluoroalkyl substances: are persistent chemicals that can enter wastewater systems through industrial discharges, commercial operations, consumer products, landfills, and other sources.

    Wastewater treatment plants are not designed to destroy PFAS. Some PFAS can pass through the liquid treatment process and accumulate in residuals, including sewage sludge and biosolids. If those biosolids are land-applied, PFAS may become part of the soil and groundwater management equation.

    That is why regulators are focusing on more than the biosolids pile itself. The compliance question now includes:

    • The PFAS concentration in the biosolids
    • The likely industrial sources entering the treatment plant
    • The soil and groundwater conditions at the receiving property
    • The proposed application rate and land use
    • Potential pathways to surface water, groundwater, crops, livestock, and nearby receptors

    EPA’s current biosolids framework, 40 CFR Part 503, does not contain federal PFAS pollutant limits. EPA’s current PFAS biosolids work includes a draft risk assessment and draft voluntary guidance, not a final nationwide land-application standard. The agency’s PFAS and sewage sludge page states that the draft guidance released July 1, 2026, is intended to provide voluntary recommendations.

    That federal uncertainty has pushed states to act first.

    Environmental scientist preparing PFAS biosolids samples with laboratory containers and analytical equipment

    New York: interim thresholds are already driving decisions

    New York regulates biosolids land application and biosolids products under the 6 NYCRR Part 360 series, including:

    • Subpart 361-2: Land Application and Associated Storage Facilities
    • Subpart 361-3: Biosolids Products

    New York’s primary interim PFAS policy is DMM-7, Biosolids Recycling in New York State: Interim Strategy for the Control of PFAS Compounds. The policy applies to biosolids recycling activities and requires sampling for PFAS compounds using procedures acceptable to the New York State Department of Environmental Conservation (NYSDEC).

    DMM-7 focuses on PFOA and PFOS as indicators of industrial impacts. The interim action levels are:

    • 20 µg/kg or less, dry weight: No PFAS-specific action required under the interim policy.
    • More than 20 but less than 50 µg/kg: Additional sampling is required. If concentrations remain above 20 µg/kg for more than one year, NYSDEC may restrict recycling.
    • 50 µg/kg or greater: NYSDEC may prohibit recycling, including land application, until the concentration is reduced below 20 µg/kg.

    These values are commonly reported as parts per billion, or ppb, on a dry-weight basis.

    DMM-7 also requires facilities to sample each biosolids source and submit results to NYSDEC. Testing must generally use Draft EPA Method 1633, unless NYSDEC approves an alternative. The analysis covers the PFAS compounds included in the method: not only PFOA and PFOS.

    The policy is available in full through NYSDEC’s DMM-7 document.

    New York’s 2026 product requirements

    On June 10, 2026, NYSDEC adopted Program Policy 7a, expanding PFAS monitoring to biosolids-derived soil products, including compost and heat-dried products.

    Facilities permitted under Subpart 361-3, along with certain facilities distributing out-of-state biosolids products, must sample products for PFAS and use a laboratory acceptable to NYSDEC. A key 2026 deadline is September 8, 2026, when required sampling results are due for currently permitted facilities covered by the policy.

    This matters to more than wastewater treatment plants. Composting facilities, product distributors, municipalities, agricultural users, and property owners receiving biosolids-derived products all need a reliable chain of documentation.

    NYSDEC is also developing formal rule amendments for Parts 361-2 and 361-3. Stakeholder materials have discussed possible standards for PFOA and PFOS in biosolids and receiving soils, but those draft concepts should not be treated as final rules until formally adopted.

    New Jersey: monitoring first, numeric limits later

    New Jersey regulates biosolids and residuals through the NJPDES program, residuals permits, the Sludge Quality Assurance Regulations at N.J.A.C. 7:14C, and land-application requirements including N.J.A.C. 7:14A-20.7.

    Beneficial use of residuals as fertilizer or soil conditioner is managed through a Letter of Land Application Management Approval, commonly called a LLAMA or Class B site approval.

    NJDEP’s July 2025 PFAS strategy identifies biosolids and land application as part of the state’s broader PFAS source-management program. It also recognizes that PFAS can accumulate in wastewater residuals and may move through soil to groundwater or surface water.

    The most direct current requirement came through NJDEP’s January 13, 2025 Request for Information to Delegated Local Agencies. The requirement applies to 17 designated direct-land-application POTWs and requires quarterly sampling of:

    • Influent
    • Effluent
    • Residuals, including biosolids

    The samples must be analyzed for 40 PFAS compounds.

    NJDEP’s PFAS DLA FAQ specifies that:

    • Influent, effluent, and residuals samples must be grab samples.
    • Residuals samples must be collected at the same location used for compliance with the Sludge Quality Assurance Regulations.
    • Residuals results must be reported in µg/kg.
    • One field blank is required per sampling event.
    • Laboratories must be New Jersey-certified for EPA Method 1633 or another approved user-defined method capable of detecting the required PFAS.

    The FAQ also directs facilities to contact dwqpfas@dep.nj.gov regarding extensions, reporting, and questions about the RFI.

    Unlike New York, NJDEP’s current public materials do not identify a statewide numeric PFAS concentration limit that automatically prohibits biosolids land application. New Jersey is collecting data, evaluating Class B sites, studying soil and groundwater conditions, and developing a broader residuals strategy.

    That does not mean New Jersey operators can wait. Permit conditions, LLAMA requirements, source-control obligations, and future rulemaking can affect whether a specific land-application program remains workable.

    Soil scientist collecting a receiving-soil sample beside a permitted agricultural biosolids application field

    What operators and landowners should do now

    A defensible PFAS-in-biosolids program starts before the next sample is collected.

    1. Confirm your regulatory category

    Determine whether your facility is:

    • A New York Part 361-2 land-application facility
    • A New York Part 361-3 biosolids-products facility
    • A New Jersey POTW subject to the DLA RFI
    • A New Jersey Class B site or LLAMA holder
    • A distributor or receiver of out-of-state biosolids products

    The answer controls sampling, reporting, approvals, and agency contacts.

    2. Build a source-control record

    PFAS results are not just a laboratory issue. Track industrial users, pretreatment activities, landfill leachate contributions, commercial discharges, and process changes that may affect the wastewater stream.

    A rising PFOA or PFOS result requires more than another sample. It may require source investigation, industrial outreach, pretreatment changes, or a revised residuals-management plan.

    3. Protect sample integrity

    PFAS sampling is unusually sensitive to contamination from field clothing, tubing, waterproof materials, personal-care products, and equipment.

    Use trained personnel, laboratory-approved containers, appropriate field blanks, clean-handling procedures, and documented decontamination protocols. A technically correct result is only useful if the chain of custody and quality-control record can withstand agency review.

    4. Characterize the receiving property

    For land application, biosolids testing is only one side of the analysis. The receiving property may require baseline soil sampling, groundwater review, surface-water evaluation, agronomic-rate calculations, and receptor screening.

    That is especially important near drinking-water sources, wetlands, streams, private wells, sensitive ecological areas, and sites with a history of industrial activity.

    5. Plan for a result above the action level

    Do not wait until a result exceeds a threshold to decide what happens next. Your response plan should identify:

    • Who reviews and validates the laboratory data
    • How affected material is isolated
    • Which agency must be notified
    • Whether additional sampling is required
    • How application schedules will change
    • What alternative management or disposal options are available
    • How the result will be communicated to owners, farmers, contractors, and counsel

    Where Envicon fits

    PFAS compliance is not a single laboratory transaction. It is a field, regulatory, engineering, and documentation problem.

    Envicon helps clients connect those pieces through site investigation, soil and groundwater management, regulatory compliance, sampling coordination, construction oversight, and environmental monitoring. Our team works directly with owners, attorneys, operators, contractors, engineers, and regulators so decisions do not disappear into a consultant’s queue.

    That matters in New York and New Jersey, where the difference between a usable result and a rejected or delayed program often comes down to details:

    • Was the sample representative?
    • Was the method acceptable to the agency?
    • Were the reporting units correct?
    • Was the receiving site evaluated before application?
    • Can the source be traced?
    • Does the documentation support the decision?

    We do not just deliver a report. We help create a clear path from PFAS data to an operational decision.

    “Collaboration is not a buzzword: it’s how we work.”

    The takeaway

    New York is using interim PFAS thresholds and expanding product sampling through DMM-7 and Program Policy 7a. New Jersey is requiring targeted quarterly monitoring while developing its residuals strategy. EPA is still working toward a federal approach.

    For biosolids generators, landowners, municipalities, and agricultural users, the prudent approach is to treat PFAS as a current project-control issue: not a distant regulatory possibility.

    Test the material. Verify the site. Track the source. Document every decision.

    When the rules are moving, the cleared path belongs to the team that is already working ahead of them.

    Talk with Envicon

    Envicon Group logo

  • NJDEP Historic Fill Guidance: When the Ground Under Your Project Isn’t Natural

    NJDEP Historic Fill Guidance: When the Ground Under Your Project Isn’t Natural

    A site can look clean at the surface and still contain decades-old construction debris, ash, brick, dredge material, or other imported soil beneath it.

    That material may qualify as historic fill under New Jersey Department of Environmental Protection (NJDEP) guidance. For developers, construction managers, and contractors, the distinction matters. Treating historic fill like ordinary clean fill can stall approvals, trigger additional investigation, and create major disposal costs after excavation has already started.

    NJDEP’s Historic Fill Material Technical Guidance provides a practical framework for investigating, managing, and remediating these conditions. The right approach starts before the first truck arrives.

    What NJDEP means by “historic fill”

    NJDEP defines historic fill as:

    “Non-indigenous material, deposited to raise the topographic elevation of the site, which was contaminated prior to emplacement, and is in no way connected with the operations at the location of emplacement.”

    Historic fill can include:

    • Construction and demolition debris
    • Brick and ash
    • Dredge spoils
    • Incinerator residue
    • Fly ash
    • Non-hazardous solid waste
    • Mixed soil and imported material

    It often appears in waterfront, industrial, rail, and urban redevelopment areas across northern and southern New Jersey. The material may have been placed decades ago to raise grades, fill wetlands, support roads, or create usable land.

    Historic fill is different from contamination caused by operations at the property. A former manufacturing facility may have both: historic fill beneath the site and separate areas of concern associated with tanks, process areas, spills, or waste handling.

    That distinction affects the investigation strategy. Each potential area of concern still requires independent evaluation.

    Why historic fill creates project risk

    The most common mistake is simple: a project team assumes that excavated material is “just dirt.”

    That assumption can fail in several ways:

    1. The material contains metals or polycyclic aromatic hydrocarbons (PAHs) above applicable soil remediation standards.
    2. The fill extends deeper or farther across the property than expected.
    3. Groundwater beneath or within the fill shows impacts.
    4. The material cannot be reused as alternate fill.
    5. The soil must be characterized, transported, treated, or disposed of under a different cost structure.

    The result is usually not a theoretical compliance issue. It is a construction problem.

    A contractor may need to stop excavation while the material is characterized. A developer may face re-mobilization costs, additional laboratory analysis, revised soil management plans, and disposal pricing that was never included in the original budget. An approval may also be delayed because the proposed remedy does not match actual subsurface conditions.

    For environmental due diligence for developers in New Jersey, historic fill belongs in the schedule and budget before closing: not after excavation begins.

    Geotechnical soil core transitioning from heterogeneous urban fill to native soil with sampling equipment

    How NJDEP expects historic fill to be evaluated

    The first step is identifying whether historic fill may be present. NJDEP guidance recommends reviewing:

    • Historical maps and aerial photographs
    • Property records and prior environmental reports
    • Site grading and development history
    • NJ Geological Survey historic fill mapping
    • Subsurface boring, test pit, or trench logs
    • Field observations such as brick, ash, debris, odor, staining, and soil discoloration

    Borings, test pits, or trenches should generally extend below the suspected fill to identify the transition to native soil, meadow mat, or bedrock. Field screening with instruments such as a photoionization detector (PID) can help identify conditions that may point to additional, non-historic-fill areas of concern.

    Once historic fill is confirmed, the remediating party generally has two paths.

    Option 1: Assume the historic fill is contaminated

    The remediating party may assume that the historic fill exceeds the applicable residential soil remediation standards and proceed with the remedial investigation.

    This path can save time when the fill is visibly heterogeneous, widespread, or difficult to sample representatively. It does not eliminate the need to understand the fill’s thickness, horizontal extent, composition, groundwater relationship, or construction implications.

    Assumption is a regulatory strategy: not permission to move the material without controls.

    Option 2: Sample the fill to demonstrate compliance

    The remediating party may collect samples to demonstrate that the historic fill does not exceed NJDEP’s residential soil remediation standards.

    NJDEP’s guidance identifies several sampling considerations, including:

    • A minimum of two sample locations per acre of historic fill
    • A discrete six-inch sample interval for homogeneous fill
    • Separate six-inch samples from distinct fill strata
    • Analysis for PAHs and metals
    • Complete TCL/TAL analysis and extractable petroleum hydrocarbons (EPH) for a portion of samples, with a minimum of one sample per stratum or fill type

    The appropriate program depends on the site, the proposed use, the fill profile, and the regulatory pathway. A generic sampling grid is not a substitute for professional judgment.

    If results show that contaminants exceed applicable standards, the site moves into a remedial investigation and remedial action process.

    What happens when contamination exceeds standards?

    If contaminated historic fill remains in place, NJDEP typically relies on a combination of engineering and institutional controls to prevent exposure.

    Engineering controls may include:

    • Asphalt or concrete pavement
    • Building slabs
    • Clean soil caps
    • Geotextile separation layers
    • Engineered barriers in landscaped areas
    • Other protective cover systems appropriate to the site use

    Institutional controls generally include a Deed Notice describing the contamination, the affected areas, the required controls, and the limitations on future disturbance or use. A soil remediation permit may also be required to ensure that the cap remains protective over time.

    The remedy has to work with the civil design. Elevations, utility trenches, foundations, stormwater features, landscaping, and future maintenance all affect whether a proposed cap will remain intact.

    Three-dimensional cutaway showing contaminated historic fill beneath clean soil, geotextile, pavement, and a building slab

    A cap designed without coordination with the civil engineer can create problems during utility installation. A deed notice prepared without matching the final site plan can create problems during review, financing, or future property transfer.

    This is where integrated environmental and civil oversight matters. The remedy should support the build: not become a separate obstacle to it.

    Can historic fill be reused on the site?

    Sometimes. But not automatically.

    If historic fill will be moved and reused as alternate fill at a site undergoing remediation through the NJDEP Site Remediation Program, the material must be evaluated under the Department’s Fill Material Guidance for SRP Sites.

    The evaluation considers whether the proposed fill is appropriate for the receiving area and whether placement would worsen site conditions. Depending on the material and location, the review may involve:

    • Traditional contaminants such as metals, PAHs, volatile organic compounds, and other site-specific constituents
    • Current applicable soil remediation standards
    • Comparison of donor and receiving-area conditions
    • “Like-on-like” considerations
    • Statistical evaluation of the available data
    • Emerging concerns such as PFAS when relevant to the site history or regulatory review

    Historic fill that exceeds applicable standards cannot simply be labeled “alternate fill” and placed elsewhere. NJDEP approval may be required. In some cases, the material must be recycled at an authorized facility or managed as a regulated waste stream.

    The practical rule is straightforward:

    Do not move historic fill first and investigate reuse later.

    Characterize the material before excavation, identify the proposed destination, and build the soil management plan around an approved path.

    Organized construction soil management area with covered historic fill, clean fill, sample jars, and separation controls

    A better preconstruction workflow for NJ projects

    For developers and construction teams, the most reliable approach is to connect environmental due diligence, regulatory strategy, and construction planning from the start.

    Before closing or mobilization, confirm:

    • Whether historic fill is likely based on historical records and NJGS mapping
    • The expected thickness and horizontal extent of the fill
    • Whether the fill is homogeneous or layered
    • Which contaminants should be included in the analytical program
    • Whether groundwater sampling is needed
    • Whether the material may remain in place, be excavated, or be reused
    • Whether caps, Deed Notices, soil permits, or groundwater controls will affect design
    • How excavated soil will be segregated, documented, transported, and disposed of
    • Whether PFAS or other emerging concerns require additional evaluation

    This process gives the owner a decision before the excavator is on site. It also gives the contractor a workable plan instead of a vague environmental condition buried in a report.

    At Envicon Group, we combine soil and groundwater management, NJ LSRP support, remedial planning, regulatory coordination, and construction oversight. Our team works directly with project stakeholders and NJDEP rather than handing off a report and leaving the construction team to interpret it.

    That difference is important. Large firms may provide a technically complete document, but the project still needs someone to connect the findings to excavation sequencing, disposal pricing, civil plans, agency comments, and field decisions. We stay involved through those handoffs.

    The takeaway

    Historic fill is not automatically a reason to abandon a New Jersey development site. It is a condition that needs to be identified, characterized, and managed deliberately.

    The project risks are predictable:

    • Delayed approvals
    • Unplanned remedial investigation
    • Re-sampling and re-mobilization
    • Unexpected disposal costs
    • Rejected alternate-fill proposals
    • Caps or deed restrictions that do not match the design

    Early investigation creates options. It may support a clean-fill determination, justify an assumed-contamination remedy, preserve appropriate reuse opportunities, or allow the project team to price disposal before construction begins.

    The ground under your project may not be natural. Your environmental strategy should account for that before the schedule depends on it.

    Sources and regulatory references

    Get a clear path forward

    Historic fill should not surprise your project team after excavation starts. Envicon Group can help you evaluate the subsurface conditions, plan soil management, coordinate with NJDEP, and keep the development moving.

    Envicon Group logo

  • Phase I ESA Cost in NYC & NJ: What You’re Really Paying For in 2026

    Phase I ESA Cost in NYC & NJ: What You’re Really Paying For in 2026

    A Phase I ESA is often treated as a line item in a real estate budget. That’s a mistake.

    In New York City and New Jersey, the right Phase I Environmental Site Assessment can protect a closing, support lender approval, and give you a clear path to the next step. The wrong one can create more questions than answers: after you’ve already paid for the report.

    So, what should you expect to pay for a Phase I ESA cost in NYC or NJ in 2026? More importantly, what are you really paying for?

    The short answer: Phase I ESA cost in NYC & NJ

    For a standard commercial property, a Phase I ESA performed under ASTM E1527-21 typically costs:

    Scope Typical 2026 cost
    Standard Phase I ESA $2,200–$4,500
    Rush Phase I ESA with approximately 1-week turnaround $3,000–$5,500
    Complex, industrial, or historically challenged property Often above the standard range

    These are planning ranges, not fixed prices. A small office property with a clean history will not require the same level of work as a former gas station, dry cleaner, manufacturing facility, or multi-building industrial parcel.

    The cost depends on the amount of environmental risk that must be investigated, documented, and explained.

    For a project-specific estimate, use Envicon’s cost estimator.

    What a Phase I ESA actually does

    A Phase I ESA is a records-based and site-observation investigation. It does not typically include soil or groundwater sampling. Its purpose is to identify potential recognized environmental conditions, or RECs, connected to the property.

    A properly completed Phase I ESA generally considers:

    • Current and historical property use
    • Current and historical uses of adjoining properties
    • Federal, state, and local environmental databases
    • Historical aerial photographs, fire insurance maps, and city directories
    • Interviews with owners, occupants, and other knowledgeable parties
    • On-site observations
    • Aboveground and underground storage tanks
    • Spills, releases, drains, pits, sumps, and waste handling
    • Environmental liens, activity and use limitations, and institutional controls
    • Data gaps that could affect the conclusions

    The standard matters. ASTM E1527-21 is the baseline environmental due diligence standard for many commercial real estate transactions. The U.S. Environmental Protection Agency recognizes ASTM E1527-21 as consistent with the federal All Appropriate Inquiries rule under 40 CFR Part 312. See the EPA’s All Appropriate Inquiries guidance.

    “AAI is the process of evaluating a property's environmental conditions and assessing potential liability for any contamination.” : U.S. Environmental Protection Agency

    That process is not just paperwork. It can affect whether a lender is comfortable funding the deal and whether a buyer can make informed decisions about future environmental liability.

    Overhead technical workspace with site plans, property records, and environmental due diligence materials

    Why two Phase I ESA quotes can be thousands apart

    A low Phase I Cost may look attractive during acquisition. But price differences usually reflect differences in scope, research depth, turnaround, and professional judgment.

    1. Property size and site complexity

    A single-story retail building on a small parcel generally takes less time to review than a multi-building industrial campus.

    Larger properties may require:

    • More extensive site reconnaissance
    • Review of multiple historical uses
    • More adjoining-property research
    • Additional interviews
    • Review of separate regulatory files
    • More detailed mapping and documentation

    The acreage itself is only part of the issue. A compact urban property can be more difficult than a large suburban parcel if records are fragmented or surrounding uses create potential environmental concerns.

    2. Prior use

    Property history is one of the most important Phase I ESA cost drivers.

    A former gas station, dry cleaner, metal shop, auto repair facility, printing plant, warehouse, or manufacturing property usually requires more analysis than a property with a straightforward office or residential history.

    Common concerns include:

    • Petroleum releases
    • Solvent and chlorinated solvent use
    • Floor drains and sumps
    • Former tanks
    • Chemical storage
    • Waste disposal
    • Historical spills
    • Vapor migration from nearby properties

    In NYC, dense development means a property’s environmental history cannot be reviewed in isolation. A nearby dry cleaner or former industrial operation may affect the risk assessment even when the subject site itself appears clean.

    In New Jersey, former industrial and commercial properties may also involve state case files, historic underground storage tanks, and regulatory programs that require careful interpretation.

    3. Records availability

    Some properties have an organized file history. Others require work across multiple sources and agencies.

    Records may come from:

    • NYC Department of Environmental Protection
    • NYC Office of Environmental Remediation
    • New York State Department of Environmental Conservation
    • New Jersey Department of Environmental Protection
    • Local building and fire departments
    • County or municipal health departments
    • Federal environmental databases
    • Prior owners, consultants, attorneys, or property managers

    When records are incomplete, the environmental professional must use sound judgment and document the limitations. That takes time. It also makes the final report more valuable.

    4. Agency file review

    A database hit is not the same as understanding the underlying file.

    A property may appear in a regulatory database because of an old spill, a closed tank, a remedial program, or a nearby site. The important questions are:

    • What actually happened?
    • Was the issue closed?
    • Were cleanup obligations completed?
    • Are restrictions still active?
    • Does the condition affect the subject property?
    • Does the issue create a current REC or another concern?

    Agency file review can add cost, but skipping it can create a much larger problem later.

    5. Vapor encroachment screening

    A standard Phase I ESA does not automatically answer every vapor-related question.

    Depending on site history and surrounding uses, you may need an ASTM E2600-22 vapor encroachment screening. This evaluates whether volatile chemicals may be migrating through soil gas toward the property.

    A vapor screening may be especially important when the property is near:

    • Former or active dry cleaners
    • Gas stations
    • Industrial facilities
    • Solvent users
    • Known contaminated sites
    • Properties with documented soil or groundwater impacts

    The screen may be handled as an additional scope item or integrated into a broader due diligence program. If the screening identifies a potential concern, the next step could include soil gas, sub-slab, or indoor air sampling. Those are separate investigations and should not be confused with a standard Phase I ESA.

    Technical environmental cross-section showing urban foundations, layered soil, monitoring points, and vapor migration pathways

    6. Report depth and lender requirements

    Not every lender wants the same level of documentation.

    Your lender, attorney, investor, or acquisition agreement may require:

    • ASTM E1527-21 compliance
    • A specific environmental professional statement
    • Current agency records
    • Environmental lien and activity-use limitation research
    • Vapor encroachment screening
    • Additional user-provided information
    • Updates close to the acquisition date
    • A lender-specific reliance letter or format

    A thin report may technically look complete but still fail review. When a lender flags the report, the schedule changes immediately. Closing can slip. Financing can lose momentum. In some cases, the deal falls apart.

    You’re not paying for page count. You’re paying for a report that answers the questions likely to come from the people funding, insuring, approving, or acquiring the property.

    Rush Phase I ESA pricing: what 1-week really means

    A rush Phase I ESA typically costs $3,000–$5,500 in the NYC/NJ market.

    The premium reflects compressed scheduling, faster records coordination, expedited review, and the need to move the report through quality control without cutting corners.

    Rush service does not mean skipping necessary work. It means organizing the work properly and assigning the right team immediately.

    Envicon has 1-week turnaround capability for qualifying projects. The exact schedule depends on property access, records availability, site complexity, and the information provided at the start.

    A rush assessment works best when you provide:

    • Property address and legal description
    • Current owner and contact information
    • Existing surveys or site plans
    • Prior environmental reports
    • Known tanks, spills, or regulatory matters
    • Lender or attorney requirements
    • Access to the property and key occupants

    The more complete the starting information, the faster the investigation can move.

    The cheapest Phase I ESA can become the most expensive

    A low quote can create hidden costs if the deliverable does not hold up.

    You may end up paying for:

    • Lender comments and revisions
    • Supplemental records research
    • A second site visit
    • A new consultant’s review
    • Delayed closing costs
    • Extended carrying costs
    • Re-mobilization or re-sampling
    • Renegotiation with the seller

    This is where large, generalized consulting firms often frustrate clients. The partner may present the proposal, but junior staff handle the report, regulatory coordination becomes opaque, and the final document reads like a defensive file archive instead of a decision tool.

    Envicon takes a different approach.

    We provide clean, defensible deliverables that explain what the findings mean and what should happen next. Our team works directly with developers, investors, lenders, attorneys, architects, contractors, and regulators. Collaboration is not a buzzword: it’s how we work.

    Our reported 100% lender approval rate reflects the importance of accurate scope, clear documentation, and practical conclusions. We do not write reports for CYA. We write them to move your project forward.

    Urban soil core samples, groundwater monitoring well cap, and environmental sampling equipment in a field setting

    How to budget your Phase I ESA

    Before requesting a quote, answer these questions:

    • Is the property in NYC, northern New Jersey, Hudson County, or another jurisdiction?
    • What are the current and historical uses?
    • Was the property ever used for gas, dry cleaning, manufacturing, auto repair, printing, or chemical storage?
    • Are there known tanks, spills, or regulatory files?
    • Does the lender require ASTM E1527-21 specifically?
    • Is vapor encroachment screening required?
    • Do you need a standard schedule or 48-hour turnaround?
    • Are prior reports and site records available?

    For many standard properties, budget $2,200–$4,500. For rush work, budget $3,000–$5,500. Complex conditions may require a broader scope, but the right consultant should explain why before the work begins.

    That transparency matters. You should know what you’re buying, what could change the scope, and how the findings connect to your acquisition or construction plan.

    Final takeaway

    The real Phase I ESA cost is not the number at the bottom of a proposal. It is the cost of obtaining reliable environmental information before you acquire, finance, design, or build.

    In NYC and New Jersey, a strong Phase I ESA helps you:

    • Protect the transaction timeline
    • Meet lender expectations
    • Identify environmental liability
    • Evaluate vapor and historical-use concerns
    • Make better acquisition decisions
    • Move from findings to action

    Envicon Group has spent 20 years helping clients turn environmentally challenged properties into clean, buildable, compliant assets. We bring field experience, regional regulatory knowledge, responsive leadership, and technology that keeps the project visible.

    We don’t sell reports. We sell cleared paths.

    Ready to price your Phase I ESA?

    Envicon Group logo

  • NYC OER Voluntary Cleanup Program: Turning Contaminated Sites Into Fundable Assets

    NYC OER Voluntary Cleanup Program: Turning Contaminated Sites Into Fundable Assets

    A contaminated property in New York City doesn’t have to remain a liability on your balance sheet. With the right strategy, it can become a cleaner, more valuable, and more financeable development asset.

    The NYC Office of Environmental Remediation’s Voluntary Cleanup Program: commonly called the NYC OER VCP: offers more than a compliance pathway. It can help developers and investors obtain liability protection, access grant funding, reduce soil management costs, satisfy environmental requirements, and create a clearer path to construction.

    For owners, lenders, attorneys, and community stakeholders, the central question is not simply, “How do we clean up this site?”

    It’s:

    “How do we turn environmental uncertainty into a documented path toward value?”

    What the NYC OER VCP Does

    The City Voluntary Cleanup Program is managed by the NYC Office of Environmental Remediation. It provides a structured process for investigating and cleaning up vacant, underused, and environmentally challenged properties throughout New York City.

    The program is often a fit for sites with:

    • Contaminated fill or historic industrial use
    • Localized petroleum impacts
    • Hazardous materials E-designations
    • Light to moderate contamination
    • Environmental conditions that could delay financing, permitting, or construction

    The VCP is not designed for every property. Sites that qualify as Class 2 hazardous waste sites on the NYSDEC registry may require a different regulatory path, including consideration of the New York State Brownfield Cleanup Program.

    That distinction matters. Choosing the wrong program can create avoidable delays, duplicated investigations, and uncertainty for the project team. A site-specific screening should happen before you commit to a cleanup strategy.

    Envicon supports that early decision-making through environmental assessments, site investigation, regulatory coordination, and brownfield redevelopment planning.

    VCP Benefits: Liability Closure, Funding, and Cost Control

    The value of the NYC OER VCP comes from how its benefits work together. Liability protection alone is important. So are grants and soil cost savings. Together, they can materially improve a project’s risk profile.

    1. Liability protection for owners and successors

    Once a property enrolls in the VCP, NYSDEC states that it has no plan to require additional investigation or remedial action beyond the remedy approved through OER, provided the project complies with the VCP agreement.

    After successful completion, the City provides additional protection through an OER Notice of Completion. The protection applies to the contamination addressed under the program and includes standard reopener conditions, such as the discovery of new or previously unknown contamination.

    The protection can also be assigned to successors and assigns that acquire, develop, or occupy the property, provided they follow the program requirements.

    That distinction is important for transactions. A buyer or lender doesn’t just want to know that cleanup work occurred. They want documentation that explains what was investigated, what remedy was implemented, what obligations remain, and how future parties can rely on the completed process.

    A defensible VCP file can help transform an environmental issue from an open-ended liability into a managed and documented condition.

    2. BIG Grants for qualifying brownfield projects

    The NYC Brownfield Incentive Grant, or BIG Grant, program can help fund work from early due diligence through cleanup.

    According to NYC OER’s BIG Grant guidance, qualifying projects may receive grants for:

    • Pre-development activities
    • Environmental investigations
    • OER-approved remedial work
    • Affordable housing and other community-supported projects
    • Certain bonus categories, including resilience and deeper cleanup outcomes

    Grant amounts vary by project category. Qualifying brownfield projects may receive up to $25,000 through the standard grant structure. Preferred Community Development Projects may qualify for $35,000 or $50,000 cleanup grants, depending on the project and affordability structure. Additional bonus grants may also apply.

    The practical lesson is straightforward: don’t wait until the cleanup is complete to ask about funding. Grant eligibility, qualified vendors, insurance requirements, application timing, and eligible activities should be built into the project plan from the beginning.

    Funding is not automatic. It requires the right documentation and coordination.

    Environmental field investigation equipment and urban brownfield sampling setup

    3. Clean Soil Bank savings

    Soil can become one of the largest cost variables on an urban redevelopment site. Excavation volumes, disposal classifications, trucking distances, import requirements, and timing all affect the budget.

    VCP projects may use the NYC Clean Soil Bank to dispose of surplus clean soil at no charge, other than trucking costs between sites. VCP projects may also receive clean soil at no cost when suitable material is available.

    That can reduce both disposal and import expenses. It can also make the civil design and earthwork plan more efficient.

    But soil must be properly characterized and managed. The project team needs to coordinate sampling, documentation, staging, transportation, and receiving-site requirements. A soil plan that ignores construction sequencing can create field problems even when the regulatory concept is sound.

    Envicon integrates soil disposal certification, soil management, environmental monitoring, and civil coordination so the remedy works in the real construction schedule: not only on paper.

    4. Hazardous waste fee exemption

    VCP sites that generate hazardous waste during remediation may qualify for an exemption from New York State hazardous waste taxes and fees. NYC OER identifies potential savings of up to $157 per ton.

    The savings can be significant on projects involving large excavation volumes. However, classification and eligibility must be handled carefully. Waste characterization, manifests, disposal facilities, and regulatory records all need to align.

    This is where early planning pays off. The team should understand the likely soil profiles before excavation begins, identify disposal pathways, and avoid treating waste management as a last-minute trucking exercise.

    The Enrollment Process: Start With the Right Documents

    To enroll a property in the NYC OER VCP, the project team submits:

    • A Remedial Investigation Report, or RIR
    • A Remedial Action Work Plan, or RAWP
    • A VCP application
    • A VCP agreement
    • The $1,000 enrollment fee

    As outlined in NYC OER’s enrollment instructions, the project team develops the RIR and RAWP in consultation with OER technical staff. New project applications are submitted through the EPIC Environment portal.

    The quality of the initial package matters. A report that merely catalogs contamination may satisfy a narrow reporting obligation, but it won’t necessarily answer the questions a developer, lender, attorney, or construction manager needs answered:

    • What is the nature and extent of the contamination?
    • Which exposure pathways matter?
    • What remedy supports the proposed use?
    • How will the remedy affect excavation and construction?
    • What will the cleanup cost?
    • What documentation will support closure?
    • What conditions will remain after completion?

    A strong RIR and RAWP connect environmental findings to the project’s development plan. That is the difference between producing a report and creating a path forward.

    E-Designation: Compliance Is Not the Same as Closure

    Many NYC development sites carry an environmental E-designation related to hazardous materials, air quality, or noise. These designations can affect building permits, construction requirements, and certificates of occupancy.

    For hazardous materials E-designations, the project generally requires an OER-approved investigation and remedial action plan. The cleanup must address the environmental conditions tied to the designation and the proposed development.

    VCP enrollment can provide a broader framework for satisfying those requirements while also creating access to liability protection, grants, soil resources, and fee exemptions.

    The goal is not simply to complete a sampling program. The goal is to obtain the certifications needed to remove the environmental obstacle from the development process.

    In practical terms, E-designation removal or satisfaction requires OER certification that:

    • The approved remedy is complete
    • The site has reached its full zoning development potential
    • All applicable air, noise, and hazardous materials requirements have been satisfied

    Until those requirements are addressed, environmental conditions can continue to affect permitting and occupancy. Developers should coordinate OER requirements with the architect, civil engineer, construction manager, attorney, and lender from the start.

    Completed NYC urban redevelopment site with technical overlay showing remedy completion and usable development footprint

    Why Field-First Execution Matters

    A VCP strategy can look complete in a regulatory matrix and still fail in the field.

    Unexpected soil conditions appear. Utility conflicts change excavation limits. Contractors need clear soil handling instructions. Air monitoring results affect work sequencing. A proposed remedy may need to adjust to actual site conditions without losing regulatory control.

    That requires direct coordination: not a chain of subcontractors and junior staff passing information between departments.

    Envicon is a family-owned, New York and New Jersey-based firm with 20 years of experience in environmental consulting, civil engineering, and construction oversight. We work directly with developers, attorneys, architects, contractors, and public agencies to keep decisions moving.

    Our approach is different from the large-firm model:

    • Senior professionals stay involved from investigation through closeout.
    • Deliverables focus on decisions and next steps, not unnecessary volume.
    • Field observations connect directly to design and regulatory actions.
    • Project reporting gives clients visibility into schedule, budget, deliverables, and field activity.
    • Pricing and scope are discussed clearly before surprises become change orders.
    • Local knowledge reflects daily work with NYC OER, NYSDEC, NJ DEP, and other regional agencies.

    Collaboration is not a buzzword: it’s how we work.

    A Better Way to Evaluate a Brownfield Opportunity

    Before acquiring or repositioning a contaminated NYC property, ask whether your team has answered these questions:

    • Is the NYC OER VCP the appropriate regulatory pathway?
    • Does the property have an E-designation or restrictive declaration?
    • What investigation is necessary to define the remedy?
    • Could the project qualify for BIG Grant funding?
    • Can the Clean Soil Bank reduce soil costs?
    • Could hazardous waste fee exemptions apply?
    • What documentation will the lender require?
    • How will cleanup activities affect the civil design and construction schedule?
    • What must OER certify before the site reaches full development potential?

    If those answers are unclear, the environmental risk is not yet under control.

    The right consultant should help you evaluate the opportunity, not just document the problem. At Envicon, we provide strategic brownfield redevelopment support, regulatory guidance, investigation, remedial design, construction oversight, and closeout documentation under one accountable team.

    The Takeaway

    The NYC OER Voluntary Cleanup Program can do more than bring a contaminated property into compliance. Used strategically, it can help:

    • Close environmental liability
    • Improve lender and investor confidence
    • Unlock grant funding
    • Reduce soil disposal and import costs
    • Satisfy E-designation requirements
    • Support community and affordable housing goals
    • Move an underused property toward its full development potential

    A brownfield is not defined only by what happened on the site. Its future depends on whether the environmental conditions are understood, managed, documented, and resolved.

    Envicon helps turn that uncertainty into a cleared path: so your site can move from contaminated and underused to fundable, buildable, and productive.

    Ready to Evaluate Your NYC Brownfield Strategy?

    If you’re considering VCP enrollment, E-designation satisfaction, or a brownfield acquisition, bring your project team in early. Envicon can help you identify the regulatory path, estimate the work, coordinate with OER, and build a cleanup strategy that supports the development: not delays it.

    Envicon Group logo

  • Phase II Environmental Site Assessment NJ: Scope, Sampling, and Realistic Costs

    Phase II Environmental Site Assessment NJ: Scope, Sampling, and Realistic Costs

    A Phase II Environmental Site Assessment answers the question a Phase I ESA cannot: is contamination actually present, where is it located, and how could it affect your project?

    For developers, investors, contractors, and lenders in New Jersey, that answer directly affects acquisition decisions, financing, design, permitting, and construction risk.

    A poorly scoped investigation can miss a plume and uncover it during excavation. An oversized investigation can consume budget without producing information that moves the project forward. The right Phase II ESA is neither minimal nor excessive. It is built around the site’s history, geology, likely contaminants, regulatory requirements, and development plan.

    What a Phase II ESA Does

    A Phase I ESA identifies recognized environmental conditions (RECs), historical uses, potential release areas, and other reasons to investigate further. A Phase II ESA uses field sampling and laboratory analysis to confirm or rule out those concerns.

    In New Jersey, the investigation should follow a clear conceptual site model:

    • What contaminants may be present?
    • Which environmental media could be affected?
    • Where did the release likely occur?
    • How could contamination migrate?
    • Could people, buildings, utilities, groundwater, or nearby properties be impacted?
    • What data will support the next project decision?

    NJDEP’s Technical Requirements for Site Remediation require site investigations to collect enough data to evaluate potentially contaminated areas of concern, with sampling biased toward suspected locations of greatest contamination both horizontally and vertically. See N.J.A.C. 7:26E, particularly the requirements for soil, groundwater, vapor intrusion, and quality assurance.

    That means a Phase II ESA should not rely on a generic grid or a standard number of borings. The sampling plan must reflect actual site conditions.

    Typical Phase II ESA Scope in New Jersey

    Soil Borings and Soil Sampling

    Soil borings provide direct evidence of subsurface conditions. Depending on the site, drilling may use direct-push, hollow-stem auger, or another method suited to access, geology, pavement, and target depth.

    Samples are typically collected from:

    • Former or current underground storage tank areas
    • Loading docks and chemical storage areas
    • Floor drains, sumps, pits, and process areas
    • Waste storage or disposal areas
    • Areas of staining, odors, stressed vegetation, or fill
    • Locations where historical operations suggest a release
    • Upgradient and downgradient locations for comparison

    The boring logs should document soil and fill characteristics, odors, staining, field screening results, groundwater observations, and sample depths. Composite soil samples generally aren’t appropriate for site investigation sampling under NJDEP requirements. Discrete samples provide better information about vertical and horizontal conditions.

    Groundwater Monitoring Wells

    If the Phase I, soil data, or site history indicates a potential groundwater concern, the investigation may require temporary or permanent monitoring wells.

    The purpose is not simply to collect a water sample. A useful groundwater program should help determine:

    • Depth to groundwater
    • Groundwater flow direction
    • Hydrogeologic conditions
    • Whether a dissolved plume exists
    • Whether contamination is moving on or off the property
    • Whether nearby receptors or buildings could be affected

    NJDEP’s rules require groundwater investigations to characterize hydrogeology, determine groundwater flow direction, evaluate contaminant fate and transport, and delineate the horizontal and vertical extent of contamination when standards are exceeded.

    A few wells placed without regard to groundwater flow or the suspected source area may produce laboratory data but fail to define the problem.

    Soil Vapor and Vapor Intrusion Sampling

    Volatile organic compounds (VOCs) can migrate through soil gas and enter buildings through cracks, utility corridors, floor drains, sumps, and other preferential pathways. This is known as vapor intrusion.

    Soil vapor or sub-slab sampling may be appropriate when:

    • VOCs or petroleum-related compounds are present
    • Groundwater contamination is near a building
    • A new building is planned over or near an impacted area
    • The site has a history of dry cleaning, manufacturing, fuel storage, or solvent use
    • There are basements, crawl spaces, or slab-on-grade structures
    • Subsurface utilities could create migration pathways

    NJDEP’s current rules identify vapor intrusion investigation triggers based on contamination type, distance from buildings, soil gas results, indoor air results, and other site conditions. Initial vapor intrusion samples may include sub-slab, indoor air, and ambient air, depending on the lines of evidence.

    Vapor sampling also requires careful field controls. Canister-based collection, proper purging, ambient air samples, weather documentation, and avoidance of cross-contamination are not optional details. They determine whether the results are defensible.

    Technical cross-section showing soil layers, groundwater table, monitoring wells, contaminant plume, and soil vapor zone

    Laboratory Analysis

    The analytical list should come from the site history and conceptual site model.

    Common Phase II analytes include:

    • VOCs
    • SVOCs
    • Petroleum hydrocarbons
    • PCBs
    • Metals
    • Pesticides, where historically relevant
    • PFAS, where required or supported by site history
    • Dioxins or furans for certain industrial or fill conditions

    NJDEP requires appropriate analytical methods, quality assurance and quality control procedures, chain-of-custody documentation, and laboratory data deliverables. The selected laboratory must have applicable certifications and sufficient analytical sensitivity for the project’s data quality objectives.

    A cheaper laboratory panel is not a savings if the reporting limits are too high to compare results against applicable NJDEP standards.

    What Changed for PFAS in 2026?

    On June 15, 2026, NJDEP formally adopted site remediation standards for PFNA, PFOA, PFOS, and GenX. The same rule adoption also amended the Technical Requirements for Site Remediation to require analysis for PFNA, PFOA, PFOS, GenX chemicals, and 2,3,7,8-tetrachlorodibenzo-p-dioxin when contaminants are unknown or not well documented.

    TCDD is a dioxin, not a PFAS compound. It is included in the amended analyte requirements because NJDEP treats these substances as important potential indicators at sites where the contaminant profile is incomplete.

    The NJDEP June 15, 2026 announcement explains that the adopted standards formalize interim standards that had been in place for several PFAS compounds. The amended N.J.A.C. 7:26E rule identifies the broader analytical requirements for sites where contamination is unknown or poorly documented.

    For your project, PFAS scope may depend on:

    • Firefighting foam use or training
    • Airports, fire stations, and emergency response areas
    • Plating, coating, or manufacturing operations
    • Landfills and wastewater-related uses
    • Industrial facilities with incomplete records
    • Suspected impacts to groundwater or drinking water resources

    PFAS sampling also requires specialized field protocols to limit cross-contamination. Materials such as certain waterproof clothing, treated equipment, and inappropriate plastics can interfere with sampling. These requirements can increase both field and laboratory costs.

    Phase II Environmental Site Assessment NJ Cost Range

    For typical NJ and NYC-area projects, a Phase II ESA commonly ranges from $10,000 to $50,000 or more.

    That range is broad because the scope can vary significantly. A limited investigation at a small commercial property is not comparable to a multi-acre industrial site with historic fill, several contaminant source areas, groundwater impacts, vapor concerns, and PFAS analysis.

    Major cost drivers include:

    • Site acreage and physical layout
    • Number and depth of soil borings
    • Number of temporary or permanent monitoring wells
    • Drilling method and access conditions
    • Pavement or difficult subsurface materials
    • Number of samples and environmental media
    • VOC, SVOC, metals, PFAS, PCB, or dioxin analysis
    • Soil vapor, sub-slab, indoor air, or ambient air sampling
    • Rush laboratory turnaround
    • Utility clearance and permitting
    • Data validation and reporting requirements
    • Need for NJDEP or LSRP coordination
    • Whether the work must support remediation or construction planning

    The key question is not, “How much does a Phase II cost?” It is, “What information does the project need before the next decision?”

    A proposal should separate fieldwork, laboratory analysis, reporting, regulatory coordination, and optional additional investigation. That makes it easier to compare bids and identify where a scope is either missing critical work or adding unnecessary tasks.

    Geotechnical Investigation Costs NJ

    A geotechnical investigation is related to a Phase II ESA but serves a different purpose.

    Environmental testing evaluates contamination and exposure pathways. Geotechnical testing evaluates how the ground will perform under foundations, slabs, pavement, utilities, retaining walls, and other improvements.

    In New Jersey, geotechnical investigation costs generally range from $5,000 to $25,000 for standard commercial sites. Larger or technically complex projects can exceed that range.

    Common cost drivers include:

    • Number and depth of borings
    • Standard Penetration Testing (SPT)
    • Rock coring
    • Groundwater observations
    • Test pits or difficult access
    • Foundation loads and building height
    • Pavement and subgrade testing
    • Laboratory testing such as Atterberg limits, grain size, moisture, and compaction
    • Compressible soils, fill, shallow bedrock, or variable geology
    • Site constraints in dense Hudson County, Newark, Jersey City, or other urban areas

    Environmental and geotechnical drilling can sometimes be coordinated. Shared mobilization may reduce costs, but the scopes cannot simply be merged without review. Environmental borings must be located around suspected source areas and completed using appropriate decontamination and sampling procedures. Geotechnical borings are usually located to support structural and civil design.

    Coordination works when the team plans it before mobilization.

    Close-up of layered soil cores, stainless steel sampling tools, and sealed laboratory vials

    How to Avoid Both Under-Scoping and Over-Scoping

    Before approving a Phase II proposal, ask for clear answers to these questions:

    • Which Phase I RECs does each boring or well address?
    • Why were the sample locations selected?
    • What contaminant list is included, and why?
    • Is PFAS required, recommended, or excluded?
    • How will groundwater flow direction be evaluated?
    • Is soil vapor or indoor air sampling necessary?
    • What happens if an initial sample exceeds a standard?
    • Which work is included in the base fee, and which work is optional?
    • Can environmental and geotechnical drilling be coordinated?
    • Will the report support the lender, design team, NJDEP, or LSRP?

    At Envicon Group, we don’t apply a template scope to a New Jersey site. We review the history, geology, planned construction, regulatory endpoint, and business deadline together.

    Our team works directly with developers, attorneys, contractors, architects, lenders, LSRPs, and agencies. You get clear documentation, direct communication, and a practical path from findings to action: not a report that leaves the next decision to you.

    We’ve spent 20 years working across New York and New Jersey. That field experience matters when the site has historic fill, shallow groundwater, buried infrastructure, or a contaminant profile that doesn’t fit a standard checklist.

    The Takeaway

    A Phase II ESA should be precise enough to find the problem and practical enough to support the project.

    In New Jersey, realistic Phase II budgets often fall between $10,000 and $50,000+, while standard commercial geotechnical investigations commonly range from $5,000 to $25,000. The final cost depends on the number of borings and wells, sample depths, analytical requirements, site access, hydrogeology, vapor conditions, PFAS considerations, and the level of regulatory documentation required.

    Under-scope the work, and you may discover contamination during construction. Over-scope it, and you may pay for data that does not change the decision.

    The right investigation removes uncertainty before it becomes a change order.

    Plan Your NJ Site Investigation

    Precision, speed, and trust turn environmental uncertainty into a buildable path.

    Envicon Group logo

  • NJDEP’s New RAP System: Consolidated Permits, Electronic Filing, and What LSRPs Must Know

    NJDEP’s New RAP System: Consolidated Permits, Electronic Filing, and What LSRPs Must Know

    Effective February 17, 2026, the New Jersey Department of Environmental Protection (NJDEP) changed how Remedial Action Permits are submitted, reviewed, modified, and maintained.

    The change is more than an updated form. NJDEP has moved to a consolidated RAP system that covers soil, groundwater, and indoor air. It also created five Focused RAP categories for qualifying remedial scenarios and made electronic submission mandatory for key RAP documents.

    For New Jersey developers, property owners, environmental attorneys, and Licensed Site Remediation Professionals (LSRPs), the message is straightforward:

    The permitting workflow has changed. Old submission habits can create avoidable delays.

    The new RAP system in plain terms

    Under the prior framework, soil and groundwater remedial action permits were generally handled as separate media-specific permits. NJDEP’s updated process now allows one consolidated RAP to address:

    • Soil contamination and related engineering or institutional controls
    • Groundwater contamination, including applicable monitoring requirements and Classification Exception Areas
    • Indoor air and vapor intrusion controls
    • Monitoring, operation, maintenance, and protectiveness certification requirements
    • Financial assurance information and applicable exemptions

    NJDEP’s February 17 notice states that the updated forms include “soil, ground water and indoor air components,” along with revised regulatory citations, monitoring plan requirements, fees, and financial assurance information. Read the NJDEP notice.

    For a site with multiple exposure pathways, this consolidated structure should make the permit easier to manage. It also creates a single record that must accurately connect the site investigation, remedial action, controls, monitoring, and long-term obligations.

    That connection is where many submittals succeed or fail.

    One permit does not mean one simple checklist

    A consolidated RAP reduces fragmentation. It doesn’t eliminate technical complexity.

    The LSRP still must evaluate each environmental medium, confirm the applicable remedial standards, document the remedial action, and demonstrate that the proposed controls protect human health and the environment. The application must also match the site’s actual conditions and the requirements of the selected RAP pathway.

    For example, a site may require:

    • A soil cap or restricted-use control
    • Groundwater monitoring and a CEA
    • Vapor mitigation beneath a building
    • Indoor air monitoring
    • Operations and maintenance procedures
    • A financial assurance analysis
    • GIS mapping and supporting data
    • Long-term biennial certification

    Technical cutaway illustration showing soil, groundwater, and indoor air remediation managed under one consolidated permit

    The new structure makes coordination more important, not less. A soil-only analysis that misses a vapor intrusion concern can affect the indoor air component. A groundwater remedy that extends beyond the property boundary can affect monitoring, notification, and CEA requirements. A change in ownership or site use can trigger administrative or technical updates.

    The permit has to tell one consistent story about the site.

    Five Focused RAP categories may create faster pathways

    The amendments establish five Focused RAP categories designed for expedited review of common remedial scenarios. These are condition-based pathways. If a site qualifies, the permittee must meet the specified conditions and cannot simply deviate from them without moving into a different process.

    The five categories include:

    1. Focused RAP I : Restricted-use soil remedial action
      This pathway applies to certain sites where soil contamination remains above the residential standard but is below applicable non-residential and migration-to-groundwater standards, with no engineering controls required.

    2. Focused RAP II : Presumptive remedy for soil
      This applies where the party elects to use a NJDEP presumptive remedy at a non-sensitive site. Sensitive sites can include residences, schools, and childcare centers.

    3. Focused RAP III : NJDEP-approved presumptive or alternative presumptive remedy
      The selected remedy must have the required NJDEP approval documentation.

    4. Focused RAP IV : Historic fill-only site
      This category addresses qualifying sites affected by historic fill and does not require a Person Responsible for Conducting the Remediation for the stand-alone permit.

    5. Focused RAP V : Groundwater monitored natural attenuation
      This pathway applies where the CEA remains within the property boundaries and there are no off-site receptor impacts.

    These pathways can shorten review when the site fits the criteria. They can also create problems when a consultant selects a Focused RAP without confirming every condition.

    Before choosing a focused pathway, your team should confirm:

    • Whether the site meets the category’s eligibility requirements
    • Whether the proposed remedy matches the approved conditions
    • Whether sensitive receptors or off-site impacts change the analysis
    • Whether the permit needs soil, groundwater, indoor air, or multiple components
    • Whether the supporting maps, data, certifications, and fees are complete

    A faster pathway is only faster when the application is correct the first time.

    Electronic filing is now mandatory

    As of February 17, 2026, NJDEP requires electronic submission of:

    • RAP applications
    • Remedial Action Protectiveness/Biennial Certification Forms
    • RAP Contact Information Change Forms

    These documents must be submitted electronically to srp_submissions@dep.nj.gov.

    This is a practical change with direct project consequences. Teams can no longer rely on legacy paper workflows, outdated forms, or informal submission practices. The correct form version, required attachments, naming conventions, certifications, fee information, and supporting GIS materials all need to be assembled before transmission.

    Electronic regulatory submission workflow with abstract form fields, site plans, GIS data, and approval checkpoints

    A clean electronic filing process should include:

    • Confirming the current NJDEP form and instruction version
    • Separating technical modifications from administrative changes
    • Reviewing all media components for consistency
    • Checking signatures and LSRP certifications
    • Confirming required monitoring and financial assurance information
    • Verifying GIS deliverables and institutional control boundaries
    • Maintaining a complete transmission and confirmation record

    The NJDEP Contaminated Site Remediation and Redevelopment Forms Library should be the starting point for current forms and instructions.

    IANA brings indoor air into the permit structure

    The new Indoor Air Notification Area (IANA) institutional control addresses vapor intrusion and indoor air impacts.

    An IANA functions as a defined area where indoor air concerns require notice, controls, or ongoing management. It is comparable in concept to a groundwater Classification Exception Area, but it focuses on the indoor air exposure pathway.

    Where applicable, IANA requirements may include:

    • Defining the affected area
    • Evaluating indoor air and sub-slab data
    • Preparing maps and GIS deliverables
    • Notifying affected municipalities and counties
    • Notifying building occupants within the IANA
    • Obtaining NJDEP approval and public registration
    • Incorporating mitigation, monitoring, and maintenance obligations into the RAP

    The IANA provisions are tied to N.J.A.C. 7:26C-7.5 and N.J.A.C. 7:26E-5.7. Your LSRP should evaluate the indoor air pathway early, particularly where a property includes residential use, mixed-use redevelopment, schools, childcare facilities, or occupied commercial buildings.

    GIS-style parcel map showing an indoor air notification boundary, vapor intrusion pathway, building slab, and groundwater monitoring point

    An IANA is not just a line on a map. It can affect property disclosures, tenant communications, construction sequencing, building design, and long-term operations. Missing the issue during due diligence can create friction during financing, permitting, leasing, or acquisition.

    What this means for ISRA NJ compliance

    The new RAP requirements also matter for facilities and transactions subject to the Industrial Site Recovery Act (ISRA).

    When an ISRA triggering event occurs, the responsible party must move quickly. The required General Information Notice (GIN) must be submitted within five days, and an LSRP must be retained within 45 days.

    Those deadlines are not the time to begin searching for a consultant or reconstruct the site’s regulatory history. Developers, owners, and counsel should have a process in place before a sale, closure, transfer, or change in operations creates a triggering event.

    For ISRA-related projects, the team should immediately identify:

    • The triggering event and the applicable deadline
    • The current property owner and responsible party
    • The retained LSRP and scope of responsibility
    • Existing RAPs, CEAs, engineering controls, and institutional controls
    • Potential indoor air or vapor intrusion concerns
    • Whether legacy permits should be combined
    • Whether a Focused RAP pathway is available
    • What documentation NJDEP will need for the next transaction milestone

    This is also where environmental due diligence for developers in New Jersey becomes more than a report exercise. The goal is to understand what the regulatory record means for the acquisition, financing, construction schedule, and future use of the property.

    Why the consultant behind the filing matters

    The new RAP system rewards teams that understand both the technical requirements and the way NJDEP submissions move through review.

    A firm that uses an outdated form, separates soil and groundwater analyses incorrectly, or omits an indoor air component can create a cycle of notices, re-submittals, reviewer questions, and delayed approvals. Every correction consumes time from the developer, attorney, lender, contractor, and LSRP.

    At Envicon, we approach NJDEP LSRP rules as a project delivery issue: not simply a compliance box.

    Our team supports New Jersey LSRP services, remediation, environmental due diligence, GIS documentation, and compliance and permitting. We coordinate directly with NJDEP reviewers, work alongside attorneys and development teams, and build submittals around the actual regulatory endpoint.

    That means:

    • Hands-on leadership from the first call through approval
    • Clean documentation designed to move the project forward
    • Direct coordination with the LSRP, counsel, engineers, and contractors
    • Clear tracking of deadlines, deliverables, and reviewer comments
    • Practical solutions for soil, groundwater, indoor air, and construction conditions
    • No black box and no handoff to an unknown junior team

    “Collaboration is not a buzzword: it’s how we work.”

    Takeaway: update the workflow now

    NJDEP’s February 17, 2026 RAP changes create a more unified system and potentially faster review for qualifying sites. They also raise the cost of using outdated processes.

    For every active or upcoming New Jersey project, confirm that your team has:

    • Switched to the current RAP forms
    • Moved required submissions to electronic filing
    • Evaluated all three media: soil, groundwater, and indoor air
    • Screened the site for IANA requirements
    • Reviewed eligibility for Focused RAP I through V
    • Checked existing permits for combination or modification
    • Calendarized ISRA deadlines
    • Confirmed LSRP responsibilities and certifications

    The right workflow removes uncertainty before it reaches the reviewer’s desk.

    Envicon helps developers, owners, attorneys, and LSRPs solve environmental and engineering challenges with precision, speed, and trust. We don’t just deliver services. We help clear the path to a buildable, compliant asset.

    Ready to review your RAP or ISRA workflow?

    Envicon Group logo

  • ISRA Compliance in 2026: Triggering Events, GIN Deadlines, and the LSRP Timeline

    ISRA Compliance in 2026: Triggering Events, GIN Deadlines, and the LSRP Timeline

    For New Jersey developers, property investors, attorneys, and corporate counsel, the most important ISRA deadline may arrive before closing.

    Under the Industrial Site Recovery Act, or ISRA, an owner or operator of a covered industrial establishment must address environmental obligations when operations close or ownership or operations transfer. The first deadline is immediate: a General Information Notice (GIN) must be submitted to the New Jersey Department of Environmental Protection within five calendar days of the triggering event.

    That is a short window. Missing it can compound regulatory exposure, disrupt a transaction, and create avoidable problems with lenders, buyers, and project schedules.

    The second major deadline follows quickly. The responsible party must retain a Licensed Site Remediation Professional (LSRP) within 45 days of the ISRA trigger date and notify NJDEP as required.

    Here’s how the ISRA process works in 2026, and where developers and their advisors need to focus.

    What Is ISRA Compliance in New Jersey?

    ISRA applies to certain industrial establishments identified through specific North American Industry Classification System (NAICS) codes.

    The law requires owners and operators of covered facilities to investigate and, where necessary, remediate environmental contamination connected with the site or its operations. The obligation can arise when a business shuts down, changes ownership, transfers operations, or undergoes certain corporate or asset transactions.

    NJDEP summarizes the purpose of ISRA directly:

    “ISRA requires owners of facilities with specific industrial classifications to investigate and remediate prior to property transfers when the business ceases operations or is sold.”

    The first step is determining whether the facility’s current or historical operations fall under an ISRA-listed NAICS code. That review should happen during due diligence: not after a purchase agreement is signed.

    Review NJDEP’s ISRA guidance and explore Envicon’s environmental assessment services before the transaction timeline becomes compressed.

    Industrial site plan and environmental sampling equipment used for ISRA applicability review

    The 5-Day GIN Clock: The Deadline That Creates Immediate Risk

    N.J.A.C. 7:26B-3.2 requires an owner or operator to submit a completed GIN within five calendar days after an ISRA triggering event occurs.

    Calendar days matter. Do not assume the rule means five business days.

    The clock also may start earlier than expected. Many transaction teams mistakenly use the closing date as the trigger. In practice, the trigger can occur when a binding agreement is executed or when operations cease: whichever event occurs first under the applicable rule.

    The GIN requirement can apply after events including:

    • The close of operations or the public release of a decision to close operations
    • Execution of an agreement to transfer ownership or operations
    • Signing an agreement of sale
    • Execution of a 99-year or longer lease
    • Corporate dissolution
    • A change in operations that changes the facility’s primary NAICS classification from an ISRA-subject code to a non-subject code
    • Exercise of an option to purchase
    • Sale or transfer of more than 50% of a facility’s assets within a five-year period
    • A merger or consolidation involving the facility’s owner or operator
    • A change in the person holding the controlling interest
    • Certain partnership-interest transfers that reduce assets available for remediation
    • Receivership, liquidation, insolvency, or specified bankruptcy events

    The controlling regulation provides the practical standard: the GIN must identify the site, owner, operator, applicable NAICS codes, triggering transaction, proposed closing or transfer date, authorized agent, and other required information.

    A late or incomplete filing does not make the underlying obligation disappear. It can create a record of noncompliance while the transaction is already moving forward.

    What to do when a trigger may have occurred

    If you believe an ISRA trigger has occurred, take these steps immediately:

    1. Identify the exact date and event that started the clock.
    2. Confirm whether the facility’s NAICS code is subject to ISRA.
    3. Gather ownership, operator, transaction, and site-identification information.
    4. Prepare and submit the GIN within five calendar days.
    5. Engage environmental counsel and an LSRP early.
    6. Coordinate the regulatory timeline with the purchase agreement and closing conditions.

    Do not wait for the parties to finalize every business term before evaluating the environmental trigger. The GIN deadline may already be running.

    Read the full requirements in N.J.A.C. 7:26B-3.2.

    The 45-Day LSRP Requirement

    After the ISRA triggering event, the responsible party must retain an LSRP within 45 days of the trigger date and provide NJDEP with the required retention and remediation information.

    NJDEP treats the ISRA trigger as the date remediation is initiated for purposes of this timeline. That means the 45-day period does not begin when the buyer takes possession or when construction starts. It begins with the qualifying closure, transfer, ownership, or corporate event.

    The LSRP becomes the technical professional responsible for directing the site remediation process. That work may include:

    • Preliminary Assessment and preparation of a Preliminary Assessment Report
    • Identification and evaluation of Areas of Concern
    • Site Investigation involving soil, groundwater, soil vapor, or other media
    • Remedial Investigation to define the nature and extent of contamination
    • Development of a Remedial Action Workplan
    • Remedial design and implementation oversight
    • Regulatory submissions and NJDEP coordination
    • Documentation supporting a Remedial Action Outcome

    Once an LSRP is retained, the LSRP must also complete the applicable notification requirements through NJDEP’s system. The retention process, scope of remediation, and site status should align with the transaction strategy from the beginning.

    The right LSRP does more than check a regulatory box. The LSRP should understand the property’s development plan, financing structure, construction schedule, soil-management needs, and likely regulatory endpoints.

    That alignment is critical for environmental due diligence for developers in New Jersey. A technically correct investigation can still fail to support the project if it arrives too late, leaves key data gaps, or does not address the buyer’s intended use.

    Industrial compliance timeline with blank milestones, filing materials, and environmental chain-of-custody equipment

    What Happens After the GIN?

    The GIN starts the formal ISRA process. It does not resolve the environmental condition of the site.

    The next steps depend on the facility’s history, prior investigations, recognized environmental conditions, and current site conditions.

    1. Preliminary Assessment

    The LSRP reviews historical records, regulatory databases, site operations, chemical use, storage areas, waste handling, underground storage tanks, and other potential Areas of Concern.

    The goal is to determine whether further investigation is necessary.

    2. Site Investigation

    If the Preliminary Assessment identifies potential concerns, the LSRP may conduct soil borings, groundwater sampling, soil-vapor testing, or targeted investigations around tanks, process areas, drains, loading areas, and waste-storage locations.

    The data must be compared with applicable New Jersey remediation standards and screening levels.

    3. Remedial Investigation

    Where contamination is identified, the LSRP defines its nature and extent. This is where a site moves from suspicion to an actionable technical model.

    The investigation should answer practical questions:

    • What contaminants are present?
    • Where are they located?
    • Have they migrated?
    • Are soil vapor or groundwater pathways affecting the proposed development?
    • What controls or remedial actions will NJDEP require?
    • Can construction proceed while remediation continues?

    4. Remedial Action and Closure

    The remedy may include excavation, off-site disposal, engineered caps, institutional controls, groundwater treatment, vapor mitigation, or a combination of measures.

    The final objective is an appropriate regulatory closure document, often a Remedial Action Outcome (RAO) issued by the LSRP when the remediation meets applicable requirements.

    In some transactions, a buyer and seller may structure a closing before all remediation is complete. That approach requires careful documentation, allocation of responsibility, and: where applicable: financial assurance such as a Remediation Funding Source.

    NJDEP provides additional information on remediation funding sources and ISRA forms and certifications.

    New Jersey industrial property with groundwater treatment vessels, monitoring wells, and contained soil-management area

    Why Early LSRP Coordination Protects the Deal

    The five-day GIN deadline is a filing issue. The larger business risk is failing to connect the filing with the actual transaction and remediation plan.

    A late environmental review can affect:

    • Closing conditions
    • Lender approval
    • Escrow requirements
    • Construction mobilization
    • Soil export and disposal costs
    • Vapor mitigation design
    • Property valuation
    • Representations and warranties
    • Indemnity negotiations
    • Long-term liability allocation

    This is where a field-first, regulator-facing approach matters.

    Envicon Group works with developers, investors, attorneys, contractors, architects, and public agencies across New Jersey and New York. We coordinate environmental due diligence, LSRP-led remediation, regulatory submissions, soil management, civil design, and construction oversight as one connected process.

    You should not have to call one consultant for the report, another for the regulator, and a third for field execution. Our team stays involved from the first review through project close.

    That means:

    • Direct access to experienced professionals
    • Clear deliverables built around the next project decision
    • Coordination with NJDEP, counsel, lenders, contractors, and design teams
    • Practical investigation and remediation strategies
    • Transparent communication about schedule, budget, and risk
    • Real-time visibility into project status and field activity

    Collaboration is not a buzzword: it’s how the work gets done.

    ISRA Compliance Checklist for 2026

    If your New Jersey facility may be subject to ISRA, confirm the following:

    • Is the facility associated with an ISRA-listed NAICS code?
    • Has operations ceased or will operations cease?
    • Has a sale, lease, asset transfer, merger, or change in controlling interest occurred?
    • Has more than 50% of the facility’s assets been transferred within the applicable five-year period?
    • What is the actual trigger date?
    • Has the GIN been submitted within five calendar days?
    • Has an LSRP been retained within 45 days?
    • Have the PA, SI, and potential RI requirements been evaluated?
    • Does the transaction require a Remedial Action Workplan, remediation certification, or funding source?
    • Are environmental conditions coordinated with the construction and financing schedule?

    If the answer to any of these questions is unclear, address it before the uncertainty reaches the closing table.

    The Takeaway

    ISRA compliance in New Jersey begins with timing.

    A listed NAICS code and a qualifying closure, transfer, ownership change, or corporate event can start a five-calendar-day GIN deadline. Within 45 days of the trigger, the responsible party must retain an LSRP and move the remediation process forward.

    The safest strategy is not to wait for the deadline. Identify the trigger early, confirm applicability, file accurately, and involve an LSRP who understands both NJDEP rules and the development plan for the property.

    Envicon Group helps turn regulatory uncertainty into a clear path toward a clean, buildable, compliant asset.

    Move Your New Jersey Project Forward

    Envicon Group logo
